Environmentally & Ecologically Sustainable farming

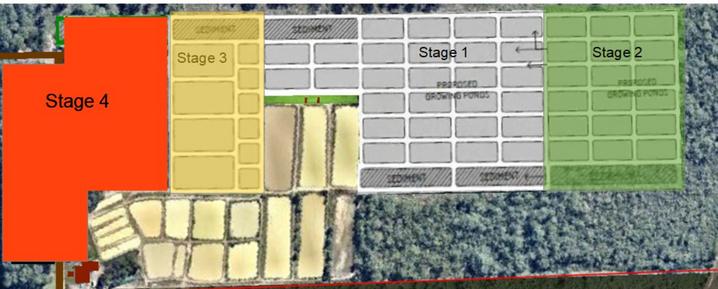

Farm Development Program

February 2021: Commercial management plan for Stages 1, 2 & 3 submitted
to DPI Fisheries.
March 2021: DPI Fisheries in principle approval received.
March 2021: Council DA application submitted.
Aug 2021: - Development plans for Stage 1 and 3 approved.
November 2021: LLS draft clearing certificate for Stage 2 issued - submitted for final approval.
November 2021: - Contractor advised significant delay in works commencing.
November 2021: New head contractor appointed - Stage 1 now estimated to be completed end Jan 2022 - 4 months ahead of schedule.
December 2021: Construction of New Crayling Hatchery building completed.
December 2021: EOI sought for 25% Equity stake in development.
January 2022: Delays due to covid work est to start early Feb.
February 2nd: Work commenced on stage 1.
February 9: Local land Sevices Land Clearing certificate issued for Stage 2
February 22: Offer for 25% equity stake received and accepted.
February 23:Contractor appointed for development works stage 2 and 3.
March 14: DA lodged for stage 2.
